Post-Merger Integration: The Acquirer's Practical Guide to Protecting Deal Value

Infographic showing the four integration priorities in post-merger integration: customers, capabilities, culture, and communication
  • Most acquisitions fail not at deal stage but during integration — here is how to protect the value you paid for.

    Written by Lee Robbins, Director at CapEQ | Originally published: August 2024

  • M&A Execution insights Series · Last updated: May 2026




    The Gist

    • Around 83% of acquisitions fail to boost shareholder returns — and poor integration, not poor strategy, is the primary cause.
    • Employee turnover averages 47% in the first year post-close; losing key people is the fastest way to destroy the value you underwrote.
    • Revenue synergies are achieved in fewer than 27% of large mergers — most acquirers overestimate them during due diligence and underinvest in realising them after close.
    • Communication failures cost more than most acquirers realise: unclear messaging in the first 90 days accelerates customer churn and talent flight simultaneously.
    • Companies that begin integration planning before signing are twice as likely to succeed as those that start after close.
    • A repeatable integration playbook — not a one-off plan — is what separates serial acquirers that create value from those that keep relearning the same lessons.

    The deal is signed. The champagne is opened. And somewhere in the building — probably in a meeting room with a whiteboard and no budget — someone is supposed to be figuring out what happens next.

    Post-merger integration (PMI) — the process of combining two organisations after a transaction — is where most M&A value is either created or destroyed. The strategy that justified the acquisition price means nothing if the combined business cannot be made to function as one.

    The data is uncomfortable but clear. A KPMG study found that 83% of deals fail to deliver any measurable improvement in shareholder returns. Research published in 2026 shows that 50% of employees at acquired UK companies leave within the first two years, and revenue synergies materialise in fewer than 27% of large-scale mergers. These are not anomalies. They are the norm for acquirers who treat integration as a post-deal afterthought.

    This guide sets out what structured, experienced acquirers do differently.


    Why integration fails before it starts

    Most acquisitions are won or lost in the planning gap — the period between signing and close, when integration should be actively designed but rarely is. Over 60% of companies lack any standardised M&A integration playbook. Each deal becomes a fresh crisis, staffed reactively, with unclear ownership and no template for decision-making.

    The second failure mode is misaligned incentives. The deal team is measured on completion. The integration team — if it exists — is measured on synergy delivery. The two groups rarely share a single definition of success.

    Third: wishful thinking on synergies. Revenue synergies, in particular, are chronically over-promised during negotiation and chronically under-delivered after close. They require two customer bases to trust each other, two sales teams to collaborate, and two product sets to be positioned coherently. None of that happens by default.

    The acquirers that consistently create value treat integration as a core organisational capability — not a project. They build repeatable processes, dedicate permanent resource, and start planning before the ink is dry.

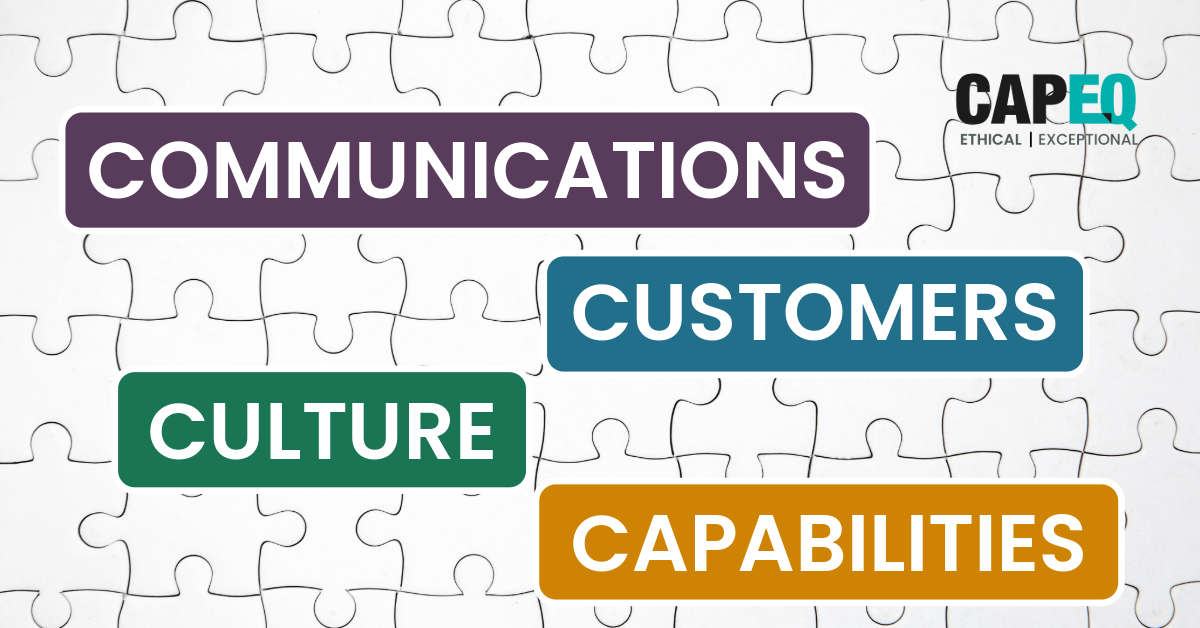

    The four integration priorities: a working framework

    Experienced acquirers organise their integration work around four areas. These are not sequential. They run in parallel from Day 1.

    1. Customers

    Customers are the most underserved stakeholder in most integrations. They did not ask to be acquired. They want to know: will my account manager change? Will my pricing change? Will my service deteriorate while you sort yourselves out?

    Silence is not neutrality — it reads as incompetence. A clear, factual communication plan for customers, delivered promptly after close, protects revenue during the transition window. Tell them what is changing, what is staying the same, and who their point of contact is.

    Any changes to products, ordering systems, billing, or account coverage need individual handling. Mass emails rarely land. Direct outreach from a named individual does.

    2. Capabilities

    The acquirer bought something specific: a team, a technology, a market position, a customer base. The integration plan must protect those things above everything else.

    Map the capabilities you are most reliant on — the people, processes, and IP that justified the acquisition price — and build your integration sequencing around preserving them. If the technical team is the asset, do not subject them to a six-month HR restructure in month one.

    3. Culture

    Culture clash is cited as a primary cause of integration failure in 25% of deals that go wrong. It is also the factor most consistently underestimated during due diligence.

    The practical challenge is that culture is rarely visible in a data room. It lives in how decisions get made (is authority centralised or devolved?), how people are motivated (financially or by recognition?), and what behaviours are tolerated when things go wrong.

    Start with a simple diagnostic — interviews, observation, and structured questions with leaders at both organisations. Identify the points of genuine alignment and the points of friction. Then design explicitly around them: adjust governance, revise appraisal criteria, update the things people actually experience day to day, not just the values statement on the wall.

    4. Communication

    Communication in the post-close period does two things simultaneously: it either builds trust or destroys it. And once trust erodes in a newly combined business, it is very difficult to recover.

    The communication plan should answer three questions for every stakeholder group: What is changing? What is staying the same? What does this mean for me? Repeat those answers in multiple formats, at regular intervals, for longer than feels necessary.
    CapEQ PMI readiness framework showing seven integration areas, common failure modes, and what good post-merger integration looks like



What poor communication actually costs: an anonymised example

A mid-2000s transatlantic telecoms merger — at the time one of the largest in the sector's history — became a case study in integration failure for a single, avoidable reason: the two organisations could not agree on a unified message for their people or their customers for the first eighteen months after close.

Staff at the acquired business were told that "everything was under review." Customers received contradictory information from account managers on different systems who themselves had no clarity on what they were authorised to say. Subscriber churn accelerated in the quarters immediately following close. Key commercial staff, uncertain about their futures, left for competitors. Within three years, the acquiring company had written down billions in goodwill and was under pressure from shareholders to reverse the deal.

The lesson is not exotic. Organisations do not fail because of complexity alone. They fail when complexity is allowed to produce silence, and silence is allowed to produce fear.

Pro tip from Lee Robbins: Write your Day 1 communication pack before you sign, not after. You won't have time after close, and the instinct to "wait until we know more" is almost always wrong. The things you do know — who the leadership team is, that services will continue, that people's jobs are not immediately at risk — are worth saying immediately, clearly, and often.


The management vacuum: what happens when no one is in charge

The second most common integration failure is structural rather than cultural: no one owns the combined business unit during the transition.

This happens more often than acquirers admit. The target's founder or CEO departs at close. The acquirer assumes the divisional director will absorb the new entity alongside their existing responsibilities. A few months pass. Performance slips. Staff lose confidence. The business that was acquired for its growth potential starts to look, from the inside, like an organisation that nobody wants.

A private-label food manufacturer acquired a specialist distribution business in 2019, partly for its regional customer relationships and partly for a proprietary logistics network. The acquisition made clear strategic sense on paper. What it lacked was an integration lead. The target's managing director had negotiated an eighteen-month earn-out and stayed on — but without a clear mandate, without access to the parent's systems, and without anyone senior at the acquirer invested in making the combination work.

By month twelve, three of the distribution business's five regional managers had resigned. The logistics network — the primary reason for the premium paid — required capital investment the acquirer had not budgeted for. The earn-out was disputed. Both parties spent more time with lawyers than with customers.

The rule is simple: every business needs a leader. If the target's management team is staying, clarify their authority and their mandate on Day 1. If they are leaving, appoint a successor before close, not after.


Technology integration: the most over-promised workstream

IT synergies are the single most consistently overstated line in any M&A business case. Fewer than 20% of acquirers successfully improve IT costs and quality after close. Systems integration typically takes twelve to eighteen months, often longer in regulated sectors.

The practical advice: unless both organisations are already using the same core platforms, do not promise system unification in Year 1. Identify the minimum viable integration — the data flows and reporting structures that need to be aligned first — and prioritise those. Everything else can follow.

Data security deserves separate attention. Any acquisition involving customer records, patient data, or proprietary IP carries regulatory exposure that needs legal and technical sign-off before integration begins, not during it.

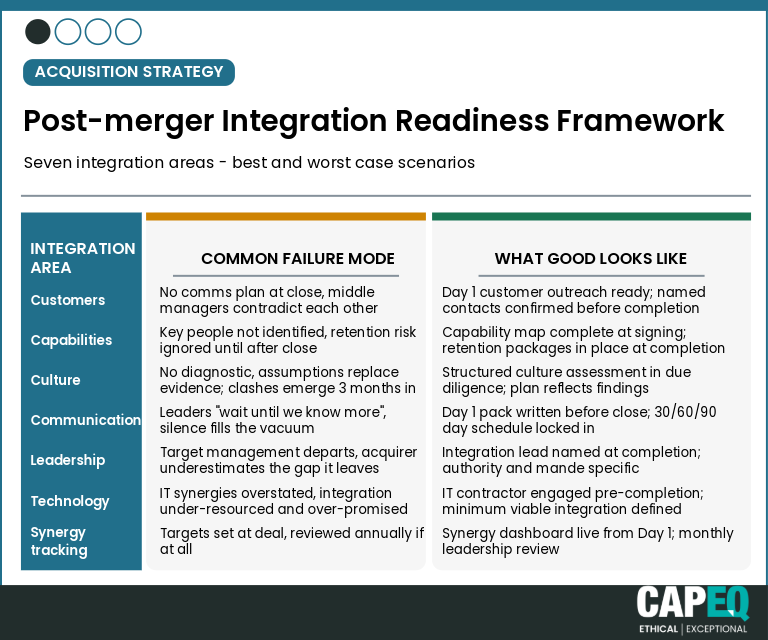

What this looks like in practice: a PMI readiness framework

Integration area Common failure mode What good looks like
Customers No communication plan at close; account managers give contradictory messages Day 1 customer letter; named contacts confirmed before close
Capabilities Key people not identified; retention risk unmanaged Capability map complete by signing; retention packages in place at close
Culture No diagnostic; assumptions replace evidence Structured culture assessment in due diligence; integration plan reflects findings
Communication Leaders "wait until they know more"; silence fills the vacuum Day 1 pack written before close; 30/60/90-day comms schedule locked in
Leadership Target management departs without replacement; acquirer underestimates gap Integration lead named at close; authority and mandate explicit
Technology IT synergies overstated; integration underresourced IT contractor engaged pre-close; minimum viable integration defined
Synergy tracking Targets set during deal; never tracked post-close Synergy dashboard live from Day 1; monthly review in leadership cadence

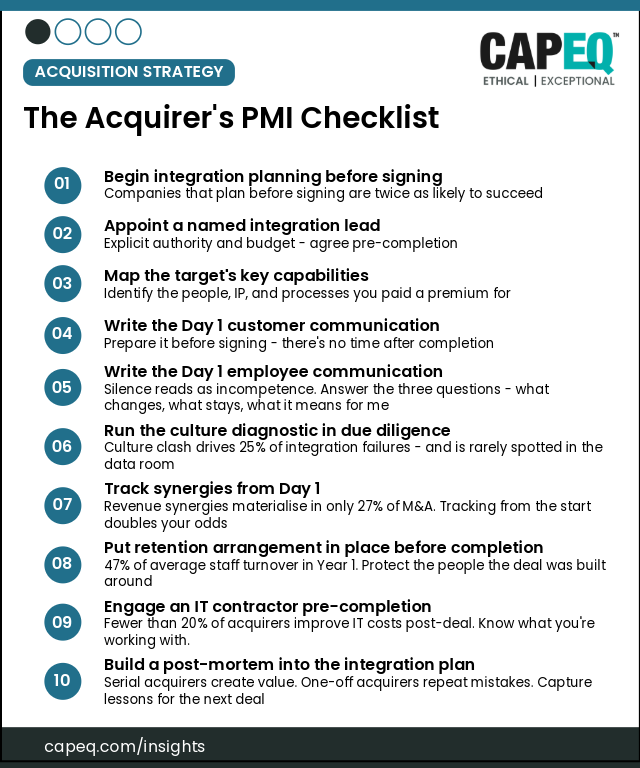

Your post-merger integration checklist

  1. Begin integration planning before signing — not after close
  2. Appoint a named integration lead with explicit authority and budget
  3. Complete a capability map of the target's key people, IP, and processes before close
  4. Write the Day 1 customer communication before you sign
  5. Write the Day 1 employee communication before you sign
  6. Conduct a structured culture diagnostic during due diligence
  7. Set synergy targets that are tracked monthly from Day 1, not reviewed annually
  8. Engage an IT contractor to assess integration complexity before close
  9. Put retention arrangements in place for key staff before completion
  10. Create a 30/60/90-day communication schedule for every stakeholder group
  11. Clarify leadership structure, roles, and decision-making authority at close — not after
  12. Build a post-mortem process into the integration plan so lessons are captured for the next deal
CapEQ_graphic2_portrait_pmi-checklist


Frequently asked questions

What is post-merger integration?

Post-merger integration (PMI) is the process of combining two separate organisations — their people, operations, systems, and cultures — into a functioning combined business after a merger or acquisition has completed. It begins at signing and typically takes twelve to twenty-four months, though complex integrations in regulated sectors can take longer. PMI is widely regarded as the phase of M&A where most deals succeed or fail: research consistently shows that strategic rationale is rarely the primary cause of value destruction, but poor integration execution is.

Why do so many acquisitions fail to deliver value?

Research from KPMG and others consistently finds that around 83% of acquisitions fail to boost shareholder returns. The most frequently cited causes are poor integration execution, cultural misalignment, talent attrition, and over-optimistic synergy assumptions. Acquirers who lack a standardised integration process — over 60% of UK companies — approach each deal reactively, which compounds these risks. Structured acquirers that begin planning before signing, appoint dedicated integration leads, and track synergies from Day 1 achieve materially better outcomes.

How long does post-merger integration take?

A well-planned mid-market acquisition typically requires twelve to eighteen months of active integration work, with the first ninety days being the most critical for stabilising people, customers, and operations. Technology integration often runs longer — an average of twelve to eighteen months for system consolidation, sometimes more. The mistake most acquirers make is declaring integration "complete" at Day 100, at which point financial and operational reporting has stabilised but cultural and capability integration is typically still in progress.

What is a Day 1 communication plan and why does it matter?

A Day 1 communication plan is a set of prepared messages — for employees, customers, suppliers, and other stakeholders — that are delivered on the first day of the combined business. Its purpose is to establish clarity before uncertainty creates its own narrative. It does not need to answer every question; it needs to confirm leadership, reassure on continuity, and set the tone. Acquirers who prepare this before close — rather than scrambling to produce it in the days after — demonstrate the organisational control that retains talent and maintains customer confidence during the transition.

When should integration planning start?

Integration planning should begin during due diligence, not after close. Companies that start integration planning before signing are twice as likely to succeed as those that begin post-completion. The integration lead should be identified before the deal is announced. A culture diagnostic, a capability map, and a Day 1 communication plan should all be ready before completion. The window between signing and close — typically four to eight weeks in a UK mid-market transaction — is the most valuable planning time available, and most acquirers waste it.
